How Long Does It Take to Build a House

Building a house isn’t as simple as calling a crew and moving in six months later.

Most first-time builders confuse “construction time” with “total project time.” Construction itself takes 4-6 months, but planning, permits, and financing add another 6-12 months. That’s 10-18 months total from idea to move-in.

The gap between these timelines causes stress, budget overruns, and blown schedules.

Understanding each stage helps you plan how long it takes to build a house realistically and avoid frustrating surprises.

From a Dream on Paper to the Day You Move In

Building a home takes time, but not all of that time is spent hammering nails and pouring concrete.

Building happens in distinct stages, some quick and others painfully slow, especially when permits or weather get involved.

Construction time is the actual building phase, where crews are on-site, framing walls, and installing systems.

Total project time includes planning, permits, financing, and design changes before any physical work begins.

Stages of Building a House and How Long Each One Takes

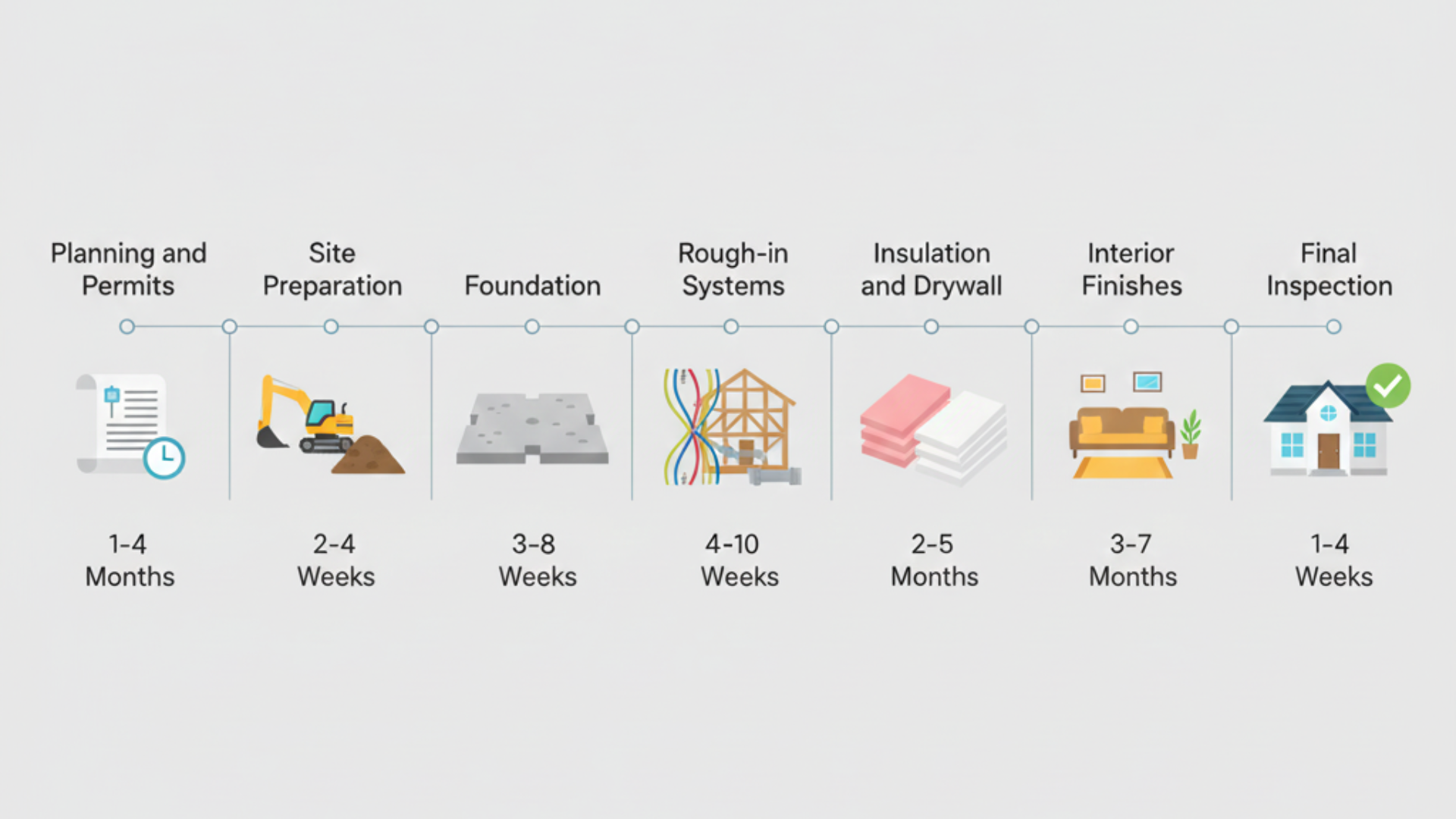

Stages of Building a House and How Long Each One Takes

Building a house happens in stages, each with a different timeline. Some take days; others stretch into weeks or months. Here’s what to expect at each step.

1. Pre-Construction (1-3 Months)

This covers land purchase, financing approval, architectural design, and permit applications.

You’ll work with architects, review blueprints, make changes, and wait for local authorities to approve your plans.

Permit delays alone can add weeks to this phase, especially in cities with strict building codes.

2. Site Preparation (1-2 Weeks)

Clearing the land, grading for proper drainage, and laying utility lines for water, sewer, and electricity.

Heavy equipment comes in to level your lot and create access roads. Weather can push this back if rain turns your site into mud.

3. Foundation (1-2 Weeks)

Excavation digs out your basement or crawl space, then concrete gets poured for footings and foundation walls.

After pouring, concrete needs 7-10 days to cure properly before framing can start.

Cold weather slows curing time significantly.

4. Framing (4-8 Weeks)

Walls, roof trusses, windows, and exterior doors go up. This is the most visible progress you’ll see; your house finally starts looking like a house.

Framing crews work fast, but material delays or bad weather can stretch this out.

5. Rough-Ins (2-4 Weeks)

Plumbing pipes, electrical wiring, HVAC ductwork, and any special systems get installed behind the walls.

Inspectors need to approve each system before you can close up walls, so schedule coordination matters here.

6. Insulation and Drywall (2-3 Weeks)

Walls get insulated for energy efficiency, then drywall goes up.

After installation, drywall needs mudding, taping, and sanding, usually requiring 2-3 coats. Each coat needs drying time between applications.

7. Interior Finishes (4-8 Weeks)

Flooring installation, cabinet mounting, countertop fitting, painting, light fixtures, bathroom fixtures, and trim work happen here.

This stage has the most variables since your material choices directly affect timing.

Custom cabinets? Add weeks. Stock options? Much faster.

8. Final Inspections and Walkthrough (1-2 Weeks)

Multiple code inspections verify everything meets local requirements.

You’ll do a final walkthrough with your builder to note any issues or touch-ups needed. Once you get your certificate of occupancy, you can legally move in.

Add it all up, and you’re looking at 4-6 months of actual construction time, but closer to 10-12 months when you factor in everything before the first shovel hits dirt.

Home Build Time by Home Type and Size

Home Type Typical Home Size Typical Build Time
Production Home 1,500–3,000 sq ft 4–6 months
Semi-Custom Home 2,000–3,500 sq ft 6–9 months
Fully Custom Home 2,500–5,000+ sq ft 9–18 months
Modular Home 1,200–2,500 sq ft 3–6 months
Tiny Home 100–400 sq ft 2–4 months
Luxury Custom Home 4,000–10,000+ sq ft 12–24 months

Real Homeowner Timelines and Experiences

Build timelines are estimates, and real experiences often vary.

  • Production homes usually finish close to schedule, with delays mainly from permits, weather, or labor shortages.
  • Semi-custom and custom homes often take longer due to design changes, upgrades, and special-order materials.
  • Modular homes build faster on-site, but factory schedules and site prep can still cause delays.
  • Tiny homes build quickly, though zoning and utility hookups may extend timelines.
  • Luxury homes typically take the longest because of complex designs and custom finishes.

Permits, inspections, weather, material delays, and homeowner changes affect timelines more than construction itself.

What Most Commonly Slows Down House Construction

Delays happen on nearly every build. Here’s what causes most of them.

Permit Approvals

Building permits can take weeks or months to process, especially in busy cities. Rejected applications send you back to resubmit, adding even more time.

Weather Conditions

Rain, snow, and extreme temperatures stop work. You can’t pour concrete in freezing weather or install roofing during storms. Winter builds often add 4-6 weeks to timelines.

Material Shortages

Custom windows, appliances, and specialty materials often have 6-12 week lead times. Late orders or supplier delays leave crews waiting with nothing to do.

Labor Shortages

Skilled tradespeople book up fast. If your contractor can’t secure electricians, plumbers, or HVAC techs when needed, you’ll wait for their next opening.

Design Changes

Every change order, moving walls, upgrading finishes, and adding features requires new approvals and pushes timelines back 1-2 weeks per revision.

Inspection Failures

Failed inspections force contractors to redo work before continuing. Each failure adds days or weeks until corrections pass review.

Most builds face at least 2-3 of these issues, so build buffer time into your schedule.

What You Can Do to Keep Your Build on Schedule

You can’t control weather or material shortages, but you can minimize delays with smart planning.

  • Finalize your design before construction starts: Mid-build changes add weeks and cost thousands in change orders.
  • Hire an experienced contractor: Check references and verify they have reliable subcontractors lined up before signing.
  • Order long-lead items early: Custom windows, appliances, and specialty materials take months to arrive.
  • Submit permit applications early: File as soon as plans are finalized and follow up regularly.
  • Stay in regular contact with your contractor: Weekly check-ins catch problems before they snowball.
  • Add 2-3 months of buffer time: Plan for delays by building a cushion into your completion date.
  • Be available for inspections: Missed appointments push timelines back by days or weeks.

Proactive planning keeps small problems from turning into big ones.

Building a House vs Buying One (Time Perspective)

The time difference between building and buying shapes everything from your budget to your living situation.

Factor Building a House Buying an Existing Home
Total Timeline 10-18 months 30-60 days
Planning & Design 1-3 months None needed
Construction Time 4-6 months Move-in ready at closing
Customization Full control over layouts, finishes, materials Limited to cosmetic changes
Housing Costs During Process Pay rent/mortgage elsewhere plus construction loan Move in immediately after closing
Immediate Repairs None, everything is new Often needed for outdated systems

What Building Requires That Buying Doesn’t

  • Permit approvals: 2-8 weeks waiting for local authorities to approve plans.
  • Months of decision-making: choosing every detail from floor plans to light fixtures.
  • Living elsewhere during construction: Paying double housing costs while your home gets built.

Building takes longer, but delivers exactly what you want. Buying gets you in fast but limits customization.

Conclusion

Now you know how long it takes to build a house; it takes longer than most people expect, but knowing the real timeline saves you from frustration and blown budgets.

The 10-18 month process includes planning, permits, financing, and construction. Each stage matters, and rushing creates bigger problems later.

If you need to move in fast, buying works better. If you want a home built exactly how you want it, the extra time is worth it.

Plan for delays, finalize decisions early, and add buffer time. Those steps keep your project on track.
